Civil works in Dubai – demolition, masonry, extensions and structural works
Strip-outs, wall removals, block work and plaster, screeds, extensions and external works – with the drawings, the propping and the approvals handled before anyone picks up a hammer.
Civil works in Dubai means the heavy, structural side of a renovation: demolition and strip-out, block work and plastering, concrete and screed, openings cut through walls, extensions, and everything outside the building line. Abdulla Carpentry EST has worked out of Ras Al Khor since 1984. A block wall built and plastered both faces runs AED 110 to 220 per square metre, a structural opening with a lintel AED 3,500 to 12,000, and a ground-floor extension shell AED 1,800 to 3,800 per square metre. The site visit and the quotation are free.
Civil contractors Dubai
People search civil works Dubai, civil works company in Dubai or civil contractors near me when something has to be knocked out, built up or held up. The trade is easy to get wrong and expensive to put right, and the difference between contractors is almost always what happens before the first hammer: whether anyone measured, drew it, and checked what the wall is actually holding.
We are a fit-out and joinery company with our own workshop in Ras Al Khor Industrial Area 2, so the civil works in Dubai that we carry out sit inside a finished job rather than ending at a rough opening. The same team that cuts the opening frames it, plasters it, and hangs the door, which is why nothing gets left in the gap between trades.
1984Working in Dubai sinceDemolition and dismantling
Demolition works are the first and messiest stage. Interior demolition and strip-out in an occupied building is a logistics job as much as a labour one: protection down, lifts booked, dust screens up, water off, and the hours agreed with building management before anything starts. We dismantle joinery, sanitary ware and ceilings for reuse or disposal rather than smashing the lot, because half of what comes out of a villa is worth keeping.


Debris removal is priced with the job, not bolted on at the end. Skip hire, municipality tipping and the labour to carry it out are all in the quotation, and an apartment strip-out is bagged and taken down by service lift rather than dropped out of a window. Our civil works in Dubai include leaving the site swept and ready for the next trade, which sounds obvious and often is not.
Wall removal and structural openings
Wall removal is the single most common reason people call us about civil works in Dubai. Partition wall removal in a block-built villa is straightforward once we have proved the wall is not carrying anything. Load-bearing wall removal is a different job entirely: it needs a structural engineer, a drawing, temporary propping, and a steel beam or reinforced lintel sized for the load before a single block comes out.

A kitchen wall removal to turn a closed kitchen into an open one is the classic Dubai villa knock-through, and it is almost always structural because of where the wall sits. An arch opening or a wide structural opening with a steel beam changes how the floor above is carried, so it is drawn, checked and propped first. Anyone who offers to do it tomorrow for a fixed price without seeing a drawing is guessing.
Block work, masonry and plastering
Block work is how most walls in Dubai are built. Concrete block walls in 100, 150 and 200 mm, brick work where it is called for, and masonry tied properly into the existing structure with starter bars rather than butted up against it and hoped for. New wall construction gets a lintel over every opening and a movement joint where the run is long enough to need one.

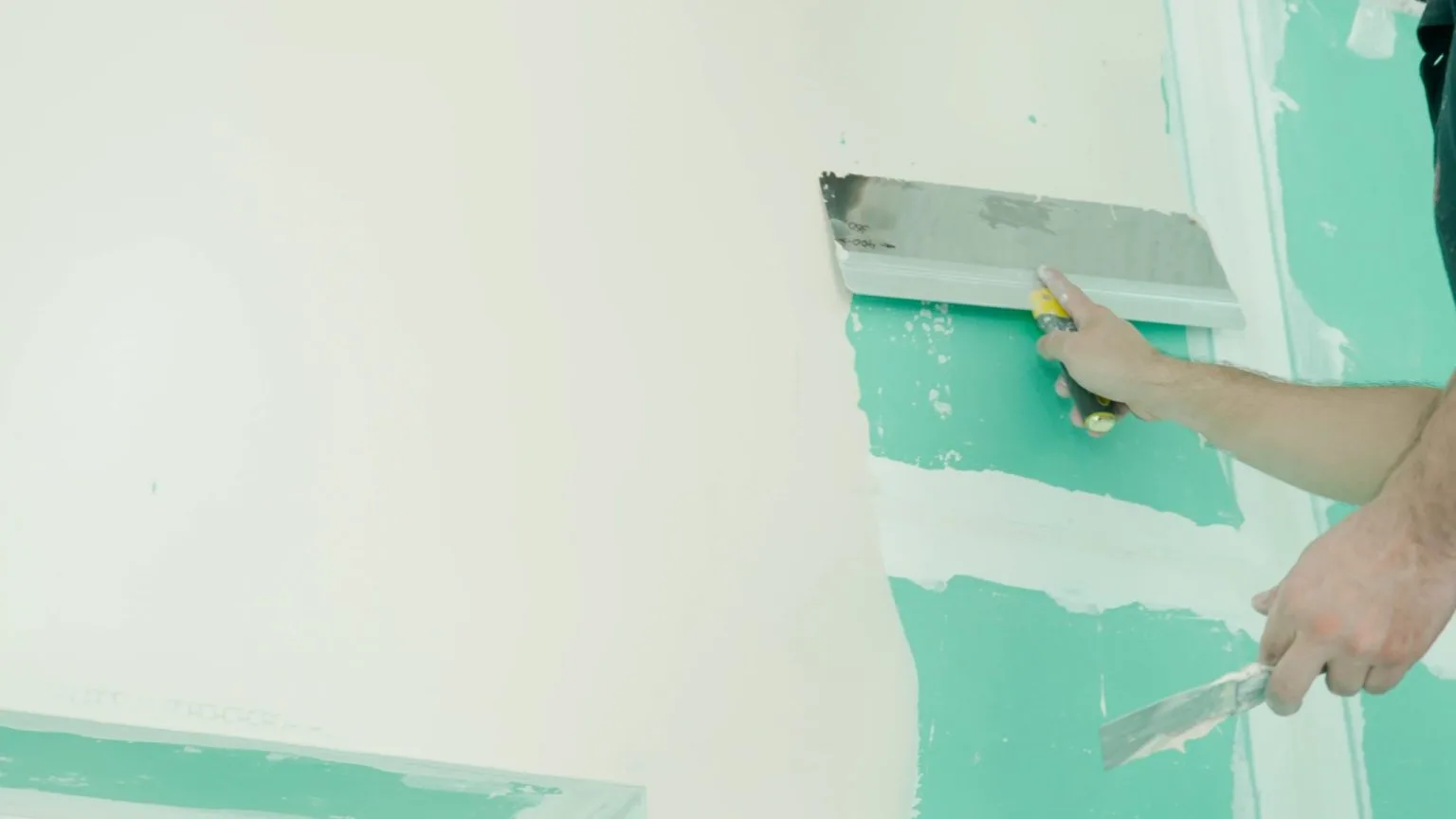

Plastering is where a good wall is either finished or ruined. Cement plaster goes on in two coats with the second ruled off straight, then a skim coat for a paint-ready face. Wall rendering and external plaster outside use a mix suited to the sun and a bell-cast at the base so water sheds instead of soaking back in. Our civil works in Dubai are handed over straight and plumb enough that the painter has nothing to argue about.
Villa extensions and room additions
Of all the civil works in Dubai we quote, a villa extension is the one that starts with what the community and the authority will allow, not with what fits on the plot. Once that is settled we build: new footings tied into the existing structure, block work up, roof slab cast, then the extension made watertight before any finishes go near it. A room extension, a majlis extension or a kitchen extension are all the same sequence at different sizes.

A ground floor extension is the simplest case. A first floor addition means proving the existing foundations and columns can carry it, which is an engineer’s job before it is ours. A roof extension, rooftop room or terrace enclosure sits somewhere in between and usually turns on whether the roof slab was designed to be built on.
The smaller additions matter just as much: a maid’s room, a guard room, a storage room, an outdoor kitchen or a BBQ area construction at the back of the garden. These are quick jobs that get treated as afterthoughts by most contractors, which is exactly why they crack, leak or sit at the wrong level a year later.
Concrete works, screeding and floor levelling
Concrete works cover everything from a small pad to a full RCC frame. Slab casting, column and beam work and lintels are set out from the drawing, reinforced to the schedule, poured and then cured properly rather than left to dry out in the sun, which is what causes the shrinkage cracking you see across so much Dubai concrete.

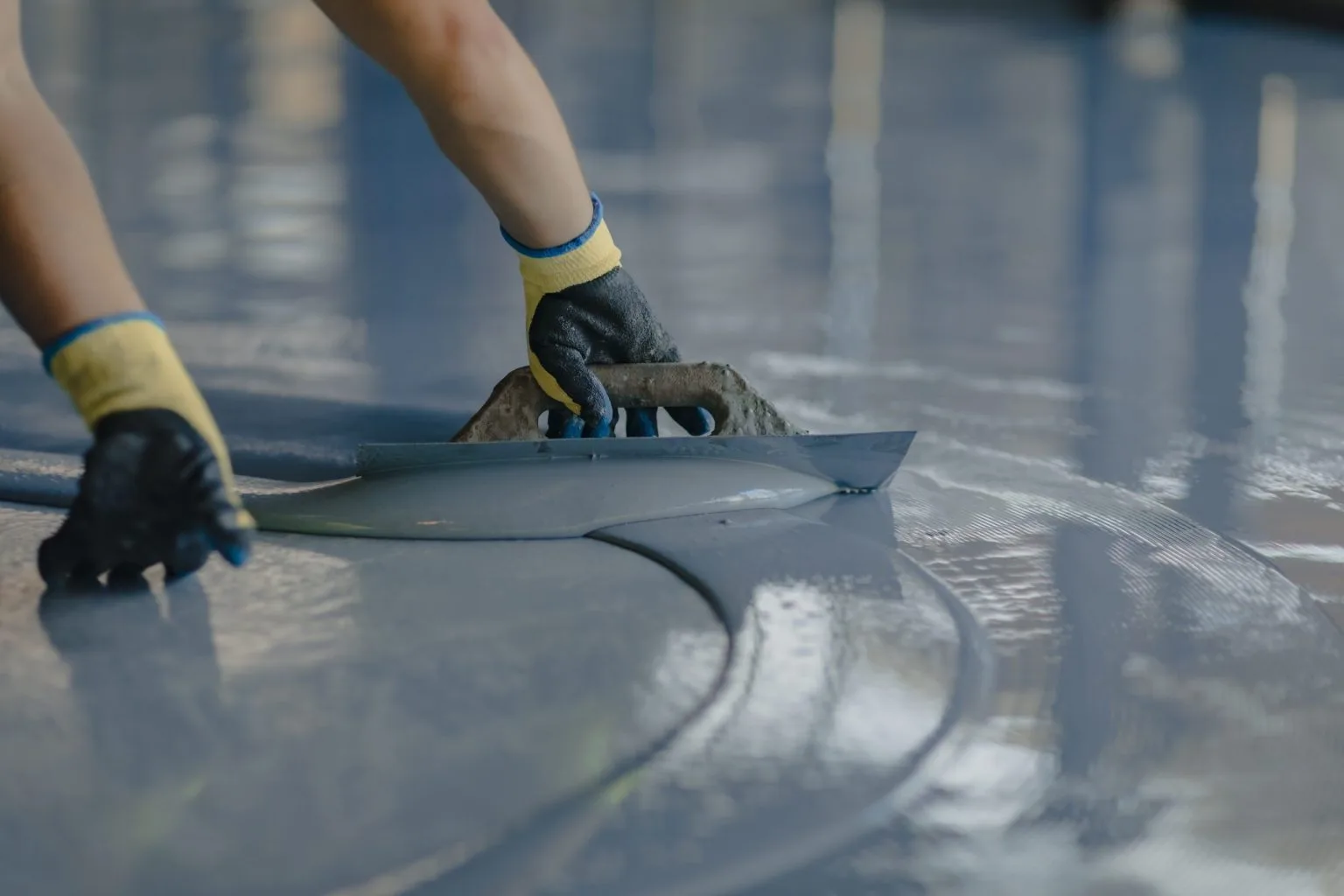

Floor screed is the part of our civil works in Dubai that nobody sees and everybody feels. A cement screed sets the level and the falls; a self-levelling compound over the top gets it flat enough for large-format tile, vinyl or engineered timber. Floor levelling done badly shows up as lipping between tiles and a wobble under a wardrobe, and a raised floor in an office has to be set out against the finished ceiling height before anything is ordered.
Structural modifications and steel supports
Structural works are the part of civil works in Dubai that should never be improvised. Any structural modification – column removal, a new opening, a slab penetration, a mezzanine – starts with a structural engineer report against the as-built drawings, and ends with steel beam installation, bearing plates and propping that stays in place until the new support is carrying the load.
Staircase construction and a new staircase opening cut through a slab are the same problem in a different direction: the opening has to be trimmed and the edge re-supported. Mezzanine construction in a warehouse or a double-height villa space is a steel job with a concrete or composite deck, and both need the drawing approved before fabrication starts, not after.
Bathroom civil works and kitchen civil works are smaller but equally unforgiving. Plumbing and electrical chasing cuts into block, not into a column or a slab, and core cutting for a drain or a duct is set out to miss the reinforcement. We scan before we cut, because a cut rebar is a repair that costs more than the whole bathroom.
External works
A boundary wall, compound wall or garden wall is a civil job with a foundation, not a stack of blocks on sand. Fence footing depth is set by the wall height and the ground, gate pillars get reinforcement and a cast core for the gate hardware, and the whole run gets movement joints so it does not crack in the first summer.

A driveway is the same discipline at ground level. Interlock paving, a car parking area, walkways and pavement all need a compacted sub-base, an edge restraint and a fall away from the building. Laid straight onto sand, interlock looks perfect for a season and then settles into ruts wherever a car turns.
We also build the civil side of the garden: a pergola base set out and cast to take the posts, swimming pool civil works around the shell, and garden landscaping civil works – planters, steps, kerbs and drainage. Waterproofing and insulation to planters, roofs and terraces runs alongside, and is detailed on our waterproofing page.
Civil works for offices, shops and warehouses
Office civil works usually start with a shell-and-core floor and a landlord’s fit-out guide. Block work to the core walls, screeds to the finished level, openings for services and making good around them are all sequenced so the MEP contractor can follow without waiting. Shop civil works are the same on a smaller footprint with a harder deadline, because rent starts whether the shop opens or not.

Warehouse civil works are about load. A mezzanine, a loading area, a dock leveller pit or a heavier slab for racking all come back to what the existing floor can take, and that is a calculation rather than an opinion. Our civil works in Dubai for commercial clients are programmed around the building’s working hours, which for a mall unit usually means nights.
How a civil works job runs
Site survey
We measure, photograph and check what every wall is carrying now.
Drawing set
A consultant drafts the structural set and a measured BOQ for it.
Permit work
Municipality permit and the developer NOC are both filed for you.
Build stage
Propping, demolition, block work, concrete, screeds and plasters.
Making good
Edges squared, debris cleared, and the site left swept and clean.
Approvals, drawings and NOCs
Nothing structural gets built in Dubai without paper. A Dubai Municipality building permit is needed for an extension, a structural alteration or anything that changes the footprint, and it is issued against drawings from a licensed consultant, not a sketch. Consultant approval and a structural engineer report come first; the permit follows.


A developer NOC is the other half. Emaar, Nakheel and Damac each run their own process for modifications inside their communities, and a master-community unit may also sit under Trakhees or the DDA depending on where it is. We tell you which of these applies at the site visit rather than after the deposit.
The drawings themselves are part of the job: a site survey, as-built drawings where none exist, a measured BOQ so the quotation can be compared line by line, and project supervision on site so the work matches the approved set. Civil works in Dubai that are built off the approved drawings are also the ones that pass inspection first time.
Civil works cost in Dubai
Civil works cost per sq ft Dubai is the way the question usually arrives, but most of this trade is priced per square metre, per metre run or per item, because that is how the work is actually done. The table below is our own rate range. A villa extension cost is driven by the shell rate and the size; a demolition cost by access and disposal; a wall removal cost by whether the wall is structural.
| Item | Unit | Typical range |
|---|---|---|
| Block wall, built and plastered both faces | per sq m | AED 110 – 220 |
| Internal plaster, to existing blockwork | per sq m | AED 40 – 85 |
| External render | per sq m | AED 55 – 120 |
| Sand-cement floor screed | per sq m | AED 55 – 110 |
| Self-levelling compound | per sq m | AED 45 – 95 |
| Falls formed in a wet area | per sq m | AED 70 – 140 |
| Structural opening with lintel, formed | each | AED 3,500 – 12,000 |
| Doorway closed and made good | each | AED 900 – 2,400 |
| Reinforced concrete slab or base | per sq m | AED 250 – 550 |
| Ground floor extension, shell | per sq m | AED 1,800 – 3,800 |
| External paving, supplied and laid | per sq m | AED 160 – 420 |
| Boundary wall, built and finished | per linear m | AED 550 – 1,400 |
| Drainage run, excavated and laid | per linear m | AED 180 – 450 |
| Making good after other trades | per day | AED 450 – 750 |
Those ranges assume reasonable access, a sound substrate and normal working hours, and they cover the civil works in Dubai listed above rather than the finishes on top. Consultant fees, permit fees and developer NOC charges are passed on at cost and shown separately, because they are not ours to mark up. Before and after civil works, the thing worth comparing is not the headline rate but what each quotation leaves out.
Permits, NOCs and who to ask
Every structural job we price is checked against the regulator’s requirements and the developer’s own rules before it is programmed. These are the sources we work from.
Civil works in Dubai: 12 best expert answers
How much does a villa extension cost in Dubai?
Our shell rate for a ground floor extension is AED 1,800 to 3,800 per square metre, so a 40 square metre majlis or kitchen extension is roughly AED 72,000 to 152,000 for the structure. Finishes, joinery, MEP and the consultant and permit fees sit on top of that and are quoted separately so you can see what each one costs.
Do I need Dubai Municipality approval to remove a wall or extend my villa?
For an extension, yes, always. For a wall removal it depends: a non-structural partition usually needs only the developer or building NOC, while removing anything load-bearing needs consultant drawings and a Dubai Municipality permit. We tell you which applies at the free site visit, before you have committed to anything.
Can a load-bearing wall be removed in a Dubai villa?
Usually yes, but not casually. A structural engineer checks the as-built drawings and the loads, sizes a steel beam or reinforced lintel, and the opening is propped before a block comes out and stays propped until the new support is bearing. Done that way it is routine. Done without a drawing it is how floors crack.
How long does a villa extension take?
Twelve to twenty weeks for a ground floor extension once approvals are in hand: about four to six weeks for footings and shell, then roof, then blockwork, plaster and finishes. The approvals themselves usually add four to eight weeks before that, and a first floor addition runs longer because the existing structure has to be proved first.
What is included in civil works?
Demolition and strip-out, debris removal, block work and masonry, plastering and rendering, concrete and reinforcement, screeds and floor levelling, structural openings and steel supports, chasing and core cutting, extensions, boundary walls, driveways and drainage. Essentially everything structural that sits under the finishes.
How much does it cost to remove a wall?
Closing a doorway and making good is AED 900 to 2,400. Forming a structural opening with a lintel is AED 3,500 to 12,000 depending on the span, the steel and the propping needed. A plain non-structural partition removal is priced with the making good, because that is usually the bigger half of the job.
Do you handle the permit and the developer NOC yourself?
We coordinate both. A licensed consultant produces the structural drawings, we submit to Dubai Municipality and to the developer or building management, and we track it through to approval. Consultant and authority fees are passed on at cost and itemised rather than buried in a rate.
Can you work in an occupied apartment or a live office?
Yes, and most of our civil works in Dubai are done that way. Protection goes down first, dust screens up, water and power isolated locally, and noisy work kept to the hours the building allows. In malls and offices that usually means nights, which is priced into the rate rather than added later.
How long does plaster need before painting?
Cement plaster needs seven days per 10 mm of thickness as a rule of thumb, so a normal two-coat wall wants a fortnight before a sealer goes on. Painting over green plaster is the single most common cause of peeling and patchy colour in a new Dubai villa.
Why does my new screed already have cracks?
Almost always curing. Screed laid in Dubai heat and left uncovered loses water at the surface faster than it can gain strength, and shrinks. We cover and cure ours, lay to the specified thickness, and use movement joints where the bay is large enough to need them.
Do you do the finishes as well, or only the civil works?
Both. We are a fit-out company first, so joinery, gypsum, painting, flooring, tiling and MEP are all in-house or under our own supervision. It means one contractor carries the opening from demolition through to the door being hung, and nobody blames the previous trade.
Which areas of Dubai do you cover?
All of it. Our civil works in Dubai reach Arabian Ranches, the Springs, the Meadows, Mirdif, Jumeirah, Umm Suqeim, Al Barsha, Dubai Hills, Damac Hills and JVC for villa work, and Al Quoz and Jebel Ali for commercial and warehouse jobs. The site visit is free wherever the property is.
Send us the wall you want gone
Photographs of the wall, the room and the ceiling above are usually enough for us to say whether it is structural and what it will take. The site visit and the quotation for your civil works in Dubai are free.
